Project and Code Planning

Overview

Under Construction

Learning Objectives

TBD

Preparation

TBD

Outline Your Analysis

Once the team has settled on a question and specific set of processes to explore or test, it’s worth sketching out the steps in your analysis. By making the inputs, processing, and outputs of each step explicit, you’ll identify needed data sooner and avoid (some) backtracking.

The process of building an explicit analysis description as a team can quickly reveal mismatches in team members’ mental models and uncover hidden assumptions. Making those (often disciplinary) differences visible early can mitigate some of the biggest risks of interdisciplinary research and also offer a way into the most novel insights. A well-structured analysis plan can also be a touchstone to return to throughout the life of your project, keeping the team on-track and avoiding mission creep.

rectangular boxes containing data sources (Si concentration, streamflow, watershed geometry and land use, watershed precipitation), linked to diamond-shaped boxed describing processing steps, linked to more rectangles with outputs

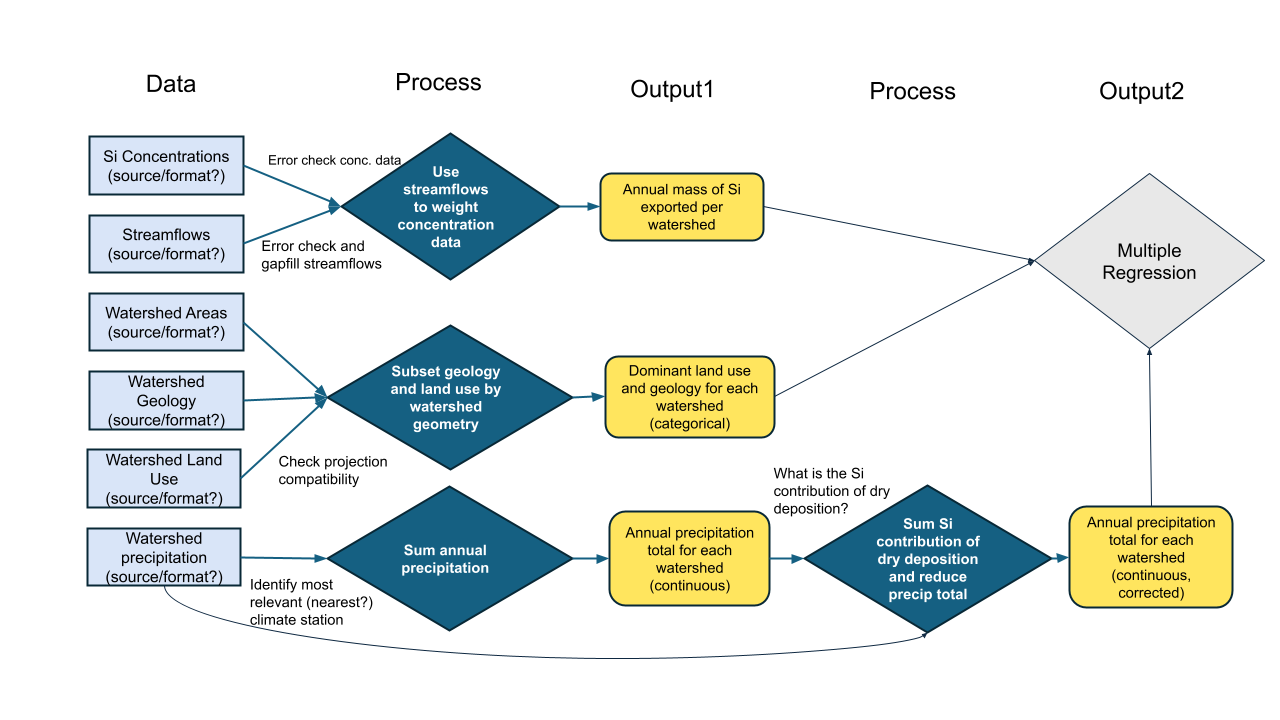

Analysis flowchart for a (relatively) straightforward test of controls on Silica exports in streamflow.

Plan the Work

Once your team goals and the necessary steps are agreed on, it becomes much easier to build a project plan that clarifies the timeline and team member responsibilities. Especially with limited-term projects such as ours, a Gantt chart can be a particularly valuable way to map out project dependencies and responsibilities. With each task arranged on a timeline, it becomes easier to spot potential dependencies that could otherwise hold up the project. With simultaneous tasks stacked vertically, it becomes apparent when the planned workload is unrealistic.

  • Before diving into any specific tool, start by making a list of your goal and the steps necessary to get there.
  • Place them into an outline in the order they must proceed.
    • Some steps cannot start until others are finished, while others can proceed simultaneously.
    • Sequential steps get a new number, while steps that can be done in parallel get the same number with different letters.
  • Attach an estimated time frame to each step and identify a responsible team member (tentative at this point).
  • Arrange the steps in colored bars along a horizontal timeline.
  • Use the visualization to assess which steps are likely to be bottlenecks and when the team may be relying too heavily on one individual for mission-critical work.

A robust support infrastructure exists for the project management profession – including formal training and a multitude of (often pricey) apps. But for the job of managing research collaborations, we’ve found that the single most important factor is whether your collaborators will use the system. For that to happen, they must have easy access to it, ideally without setting up a new account and as part of something they already do every day.

For non-coders, we’ve included a Google sheet template of a Gantt chart, pictured below.

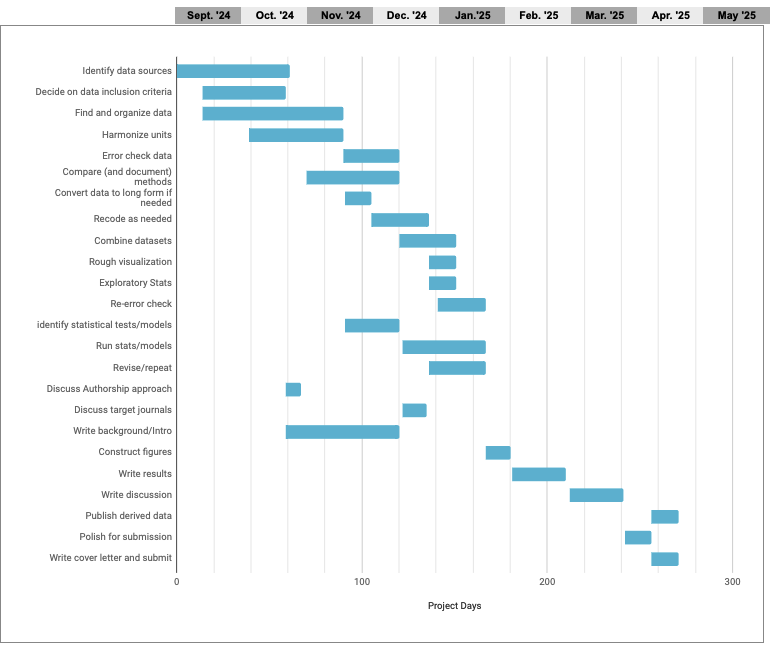

a series of overlapping horizontal colored bars represents the active work periods for several critical project tasks

But if you’re already working in GitHub or GitLab to collaborate on code, why not take advantage of GitHub’s project management capabilities? In GitHub, issues from your repos can be assigned to projects (which sit at a level above repos), allowing an overarching view of all the tasks associated with a project. Issues can also be created in the project itself. Both kinds of issues can be assigned to individuals, marked with topical tags, and assigned start and due dates. The examples below draw from the repository we are using to organize the first iteration of this course.

a series of vertical boards labelled back burner, inqueue, active progress, waiting, and done, with cards for specific tasks and individuals and due dates assigned

Organizing with GitHub Projects

Two additional views make it even easier to track overall progress and individual workloads. The “roadmap” view in GitHub functions like an interactive Gantt chart, once start and target dates are assigned to an issue. In the roadmap view, issues can by dragged forward and back in time and the issue’s start or end date will adjust accordingly. The stack of issues can be sorted by start date, target date, topic tags or assigned collaborator.

The “sliced tasks view” also allows each collaborator to see only their own assigned tasks.

a series of overlapping horizontal colored bars represents the active work periods for several critical project tasks

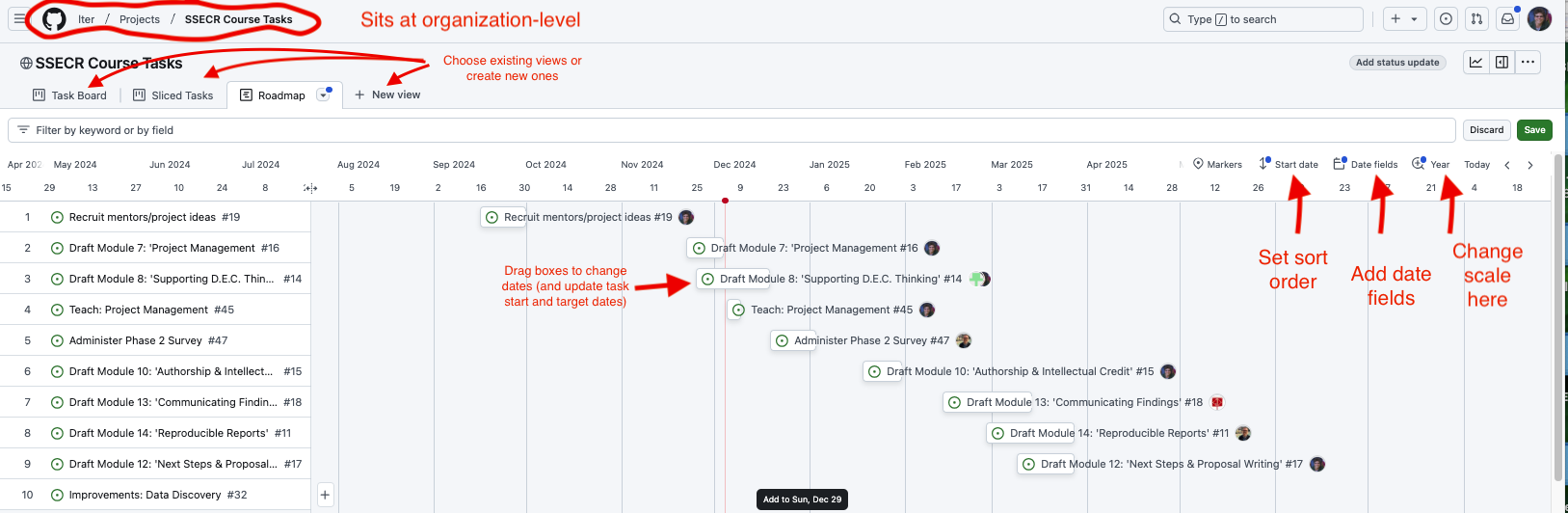

Gantt Chart Example using GitHub Projects

NoteActivity: Develop a Project Timeline/Gantt Chart

As a project group, work through the following prompts.

Instructions are included for using either GitHub or a Google sheet template to complete a project Gantt chart. GitHub has more capabilities, especially for accessing individual task lists, but the Google Sheet template is included in case group members are not yet comfortable with GitHub.

  • Decide whether you will use the Google Sheet template or GitHub
    • Click the respective tab for the next direction
  1. Access the Google sheet template, and copy it into your project folder
    • The template has two tabs
    • The manual one requires you to update the dates and graphical representation separately, but is a little more intuitive to edit and allows you to change bar color by assigned task lead
    • The “basic” tab will update the graph when you update task dates
  2. Working backwards from the end of May, estimate how long each task will take and enter it in the spreadsheet
  3. Add or remove steps as needed for your proposed project
  4. Choose task leads
    • They should expect to draw on other group members for assistance and feedback
  5. Review the chart
    • What appear to be the bottlenecks?
    • How could you mitigate them?
    • Can subgroups work simultaneously on different sub-projects?
    • Do you need to think about re-scoping the project?
  6. Revise task dates as needed
  1. Go to your project repository and find the project that has been created for you (top center menu)
    • It will open in a Kanban Board view
  2. Begin adding tasks/issues (bottom of each list). Click on the task title to open it and add a brief description
    • A nice touch here is to add a checklist of subtasks
  3. Choose task leads and add them to each task card (supporting group members can also be added)
  4. Add approximate start dates and target end dates for each task
  5. When you have most of your major tasks entered, switch to the roadmap view and shift the timelines as needed by extending the boxes or dragging them forward or back
  6. Review the chart
    • What appear to be the bottlenecks? How could you mitigate them?
    • Can subgroups work simultaneously on different sub-projects?
    • Do you need to think about re-scoping the project?
  • Regardless of which tool you used, decide on a plan for checking in and updating the Gantt chart
    • Every group meeting? Every Monday? Once a month?
  • After 30 minutes, return to whole group and discuss any insights or innovations

Making a Wrangling Plan

Before you start writing your data harmonization and wrangling code, it is a good idea to develop a plan for what data manipulation needs to be done. Just like with visualization, it can be helpful to literally sketch out this plan so that you think through the major points in your data pipeline before beginning to write code that turns out to not be directly related to your core priorities. Consider the discussion below for some leading questions that may help you articulate your group’s plan for your data.

WarningDiscussion: Wrangling Plan

With your project groups discuss the following questions:

  • What harmonization needs to be done to make your starting data files comparable?
    • Consider units, taxonomic resolution, spatial/temporal granularity, etc.
  • Once you have harmonized your data, what wrangling needs to be done?
    • Do you need to calculate index metrics? Change the ‘shape’ of the data? Aggregate to a particular spatial/temporal resolution or sampling intensity?
  • How can you make your workflow less repetitive / more efficient?
    • Reducing redundancy makes integrating new ideas dramatically easier
  • How easy will it be to maintain or revisit this code workflow?
  • How can you change the workflow now to make life easier for ‘future you’?

Harmonizing Data

For the purposes of SSECR, we’ll define “harmonization” as the process of combining separate primary data objects into one object. This includes things like synonymizing columns, or changing data format to support combination. This excludes quality control steps–even those that are undertaken before harmonization begins.

Data harmonization is an interesting topic in that it is vital for synthesis projects but only very rarely relevant for primary research. Synthesis projects must reckon with the data choices made by each team of original data collectors. These collectors may or may not have recorded their judgement calls (or indeed, any metadata) but before synthesis work can be meaningfully done these independent datasets must be made comparable to one another and combined.

For tabular data, we recommend using the ltertools R package to perform any needed harmonization. This package relies on a “column key” to translate the original column names into equivalents that apply across all datasets. Users can generate this column key however they would like but Google Sheets is a strong option as it allows multiple synthesis team members to simultaneously work on filling in the needed bits of the key. If you already have a set of files locally, ltertools does offer a begin_key function that creates the first two required columns in the column key.

The column key requires three columns:

  1. “source” – Name of the raw file
  2. “raw_name” – Name of all raw columns in that file to be synonymized
  3. “tidy_name” – New name for each raw column that should be carried to the harmonized data

Note that any raw names either not included in the column key or that lack a tidy name equivalent will be excluded from the final data object. For more information, consult the ltertools package vignette. For convenience, we’re attaching the visual diagram of this method of harmonization from the package vignette.

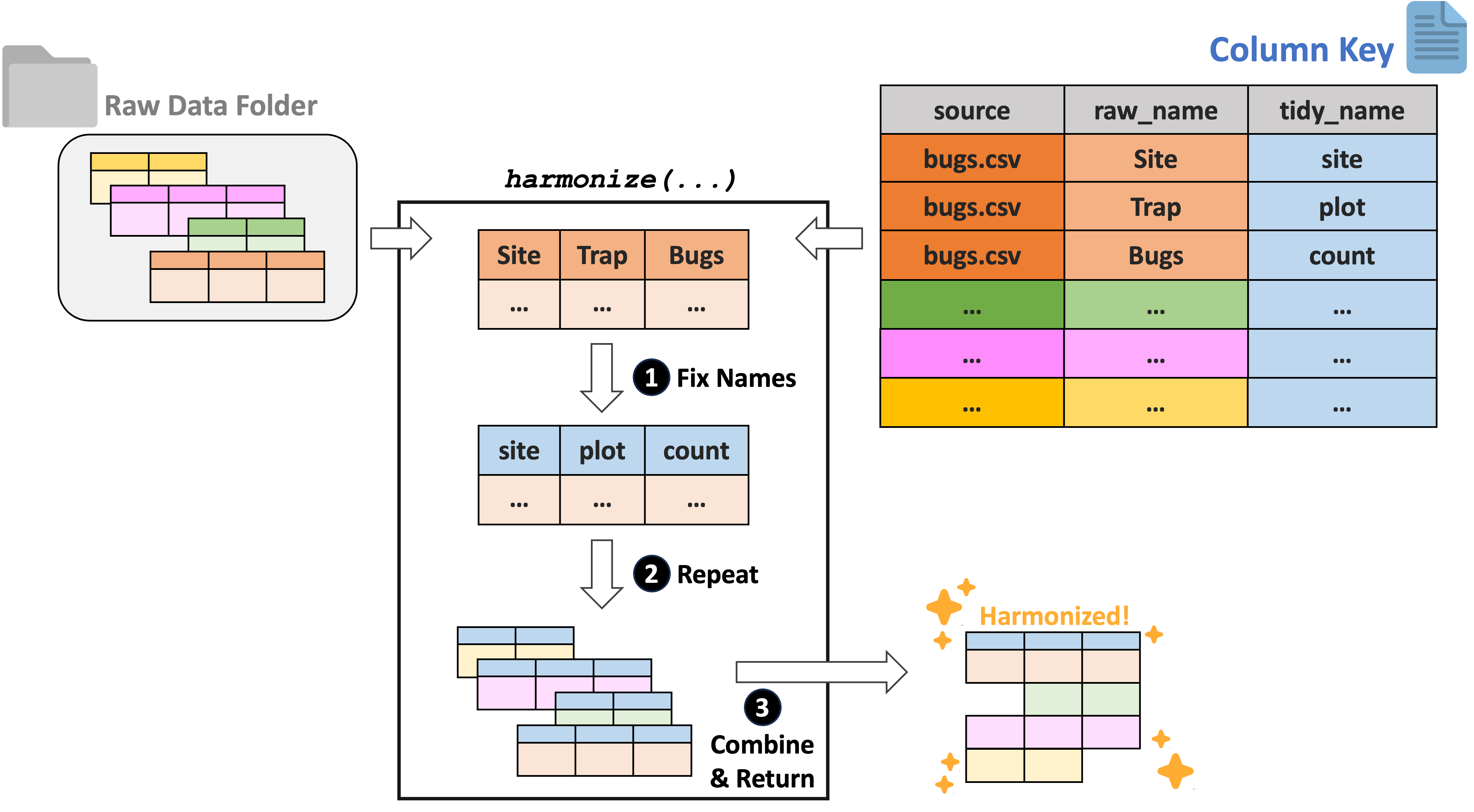

Four color-coded tables are in a soft rectangle. One is pulled out and its column names are replaced based on their respective 'tidy names' in the column key table. This is done for each of the other tables then the four tables--with fixed column names--are combined into a single data table

Wrangling Scope

For the purposes of SSECR, we’ll define “wrangling” as all modifications to a single data object meant to create a single, analysis-ready ‘tidy’ data object. This includes quality control, unit conversions, and data ‘shape’ changes to name a few. Note that attaching ancillary data to your primary data object (e.g., attaching temperature data to a dataset on plant species composition) also falls into this category!

Data wrangling is a huge subject that covers a wide range of topics. In this part of the module, we’ll attempt to touch on a wide range of tools that may prove valuable to your data wrangling efforts. This is certainly non-exhaustive and you’ll likely find new tools that fit your coding style and professional intuition better. However, hopefully the topics covered below provide a nice ‘jumping off’ point to reproducibly prepare your data for analysis and visualization work later in the lifecycle of the project.

To begin, we’ll load the Plum Island Ecosystems fiddler crab dataset we’ve used in other modules.

# Load the lterdatasampler package
library(lterdatasampler)

# Load the fiddler crab dataset
data(pie_crab)

Exploring the Data

Before beginning any code operations, it’s important to get a sense for the data. Characteristics like the dimensions of the dataset, the column names, and the type of information stored in each column are all crucial pre-requisites to knowing what tools can or should be used on the data.

Checking the data structure is one way of getting a lot of this high-level information.

# Check dataset structure
str(pie_crab)
Classes 'tbl_df', 'tbl' and 'data.frame':   392 obs. of  9 variables:
 $ date         : Date, format: "2016-07-24" "2016-07-24" ...
 $ latitude     : num  30 30 30 30 30 30 30 30 30 30 ...
 $ site         : chr  "GTM" "GTM" "GTM" "GTM" ...
 $ size         : num  12.4 14.2 14.5 12.9 12.4 ...
 $ air_temp     : num  21.8 21.8 21.8 21.8 21.8 ...
 $ air_temp_sd  : num  6.39 6.39 6.39 6.39 6.39 ...
 $ water_temp   : num  24.5 24.5 24.5 24.5 24.5 ...
 $ water_temp_sd: num  6.12 6.12 6.12 6.12 6.12 ...
 $ name         : chr  "Guana Tolomoto Matanzas NERR" "Guana Tolomoto Matanzas NERR" "Guana Tolomoto Matanzas NERR" "Guana Tolomoto Matanzas NERR" ...

For data that are primarily numeric, you may find data summary functions to be valuable. Note that most functions of this type do not provide useful information on text columns so you’ll need to find that information elsewhere.

# Get a simple summary of the data
summary(pie_crab)
      date               latitude         site                size
 Min.   :2016-07-24   Min.   :30.00   Length:392         Min.   : 6.64
 1st Qu.:2016-07-28   1st Qu.:34.00   Class :character   1st Qu.:12.02
 Median :2016-08-01   Median :39.10   Mode  :character   Median :14.44
 Mean   :2016-08-02   Mean   :37.69                      Mean   :14.66
 3rd Qu.:2016-08-09   3rd Qu.:41.60                      3rd Qu.:17.34
 Max.   :2016-08-13   Max.   :42.70                      Max.   :23.43
    air_temp      air_temp_sd      water_temp    water_temp_sd
 Min.   :10.29   Min.   :6.391   Min.   :13.98   Min.   :4.838
 1st Qu.:12.05   1st Qu.:8.110   1st Qu.:14.33   1st Qu.:6.567
 Median :13.93   Median :8.410   Median :17.50   Median :6.998
 Mean   :15.20   Mean   :8.654   Mean   :17.65   Mean   :7.252
 3rd Qu.:18.63   3rd Qu.:9.483   3rd Qu.:20.54   3rd Qu.:7.865
 Max.   :21.79   Max.   :9.965   Max.   :24.50   Max.   :9.121
     name
 Length:392
 Class :character
 Mode  :character




For text columns it can sometimes be useful to simply look at the unique entries in a given column and sort them alphabetically for ease of parsing.

# Look at the sites included in the data
sort(unique(pie_crab$site))
 [1] "BC"  "CC"  "CT"  "DB"  "GTM" "JC"  "NB"  "NIB" "PIE" "RC"  "SI"  "VCR"
[13] "ZI"

For those of you who think more visually, a histogram can be a nice way of examining numeric data. There are simple histogram functions in the ‘base’ packages of most programming languages but it can sometimes be worth it to use those from special libraries because they can often convey additional detail.

# Load the psych library
library(psych)

# Get the histogram of crab "size" (carapace width in mm)

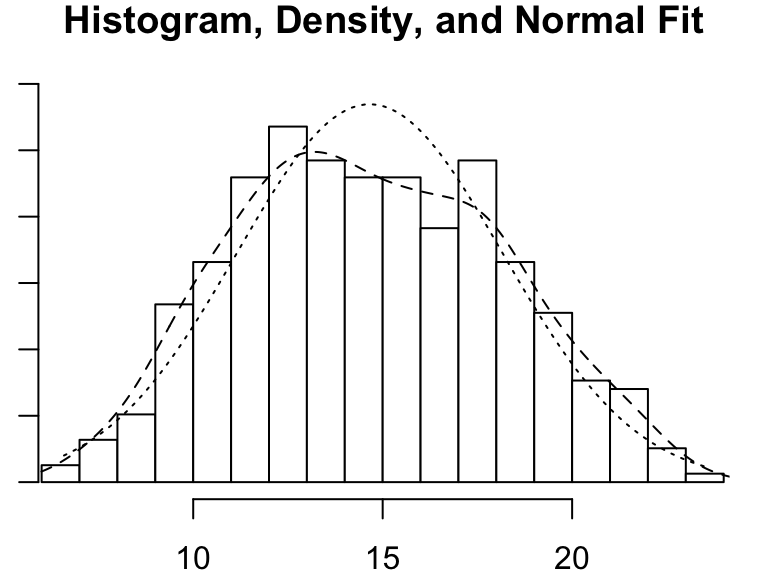

psych::multi.hist(pie_crab$size)

WarningDiscussion: Data Exploration Tools

With a group of 4-5 others discuss the following questions:

  • What tools do you use when exploring new data?
  • Do you already use any of these tools to explore your data?
    • If you do, why do you use them?
    • If not, where do you think they might be valuable to include?
  • What value–if any–do you see in including these exploratory efforts in your code workflow?
